Construction updates:
The Northfield High School Reimagine project has begun in earnest, and regular construction updates will be provided in district and building newsletters and on this webpage.

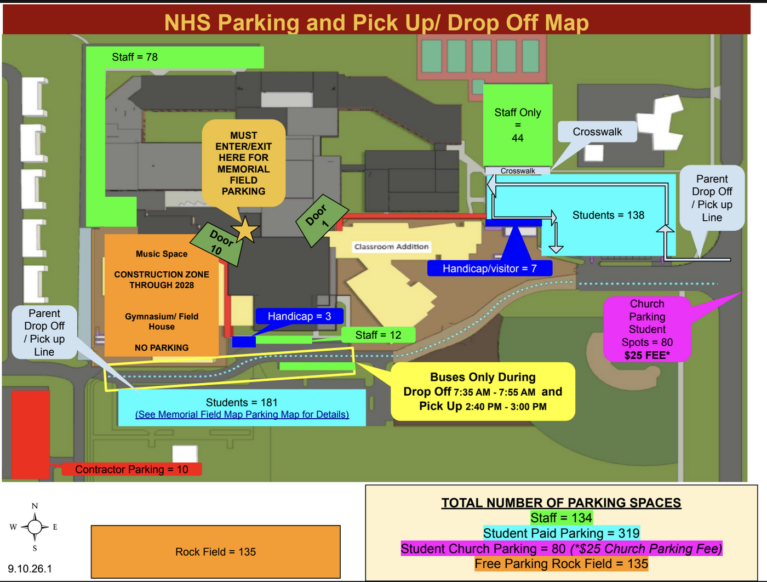

The map below shows overall parking on the Northfield High School campus, and highlights the parent pick up and drop off route, as well as designated parking for students and staff. It also highlights handicap accessible and visitor parking locations.

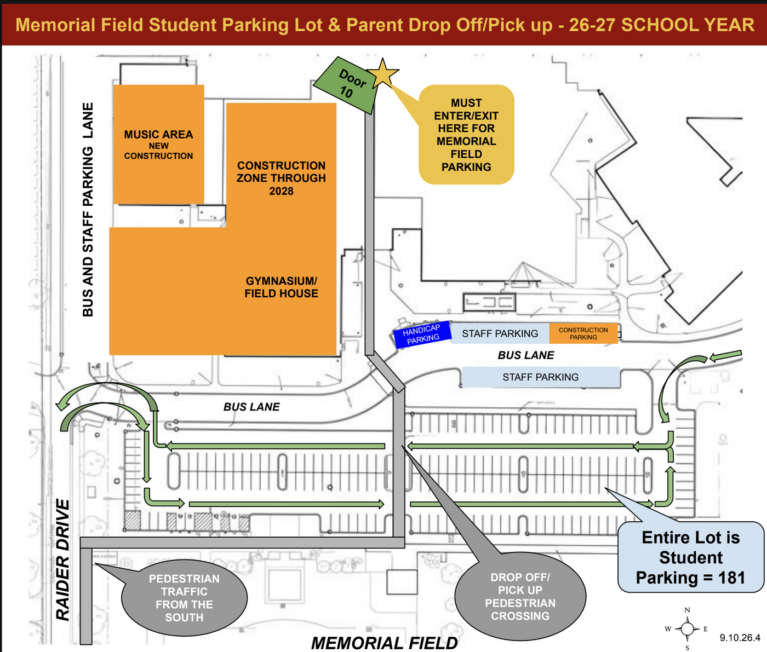

The map below highlights the new student parking lot and traffic flow for parent drop off and pick up.

Students parking in the new Memorial Field parking lot will need to enter/exit through Door 10 before, during, and after school.

Please note that due to continued progress on site, there will be increased construction traffic along Raider Drive. Only construction vehicles are to enter the construction zone through the gated fence.
Construction activity that took place the week of October 12-16, 2026:
- Poured concrete foundation walls and footings in Area Q (classroom addition).
- Backfilled newly-poured concrete walls in Area Q (classroom addition).

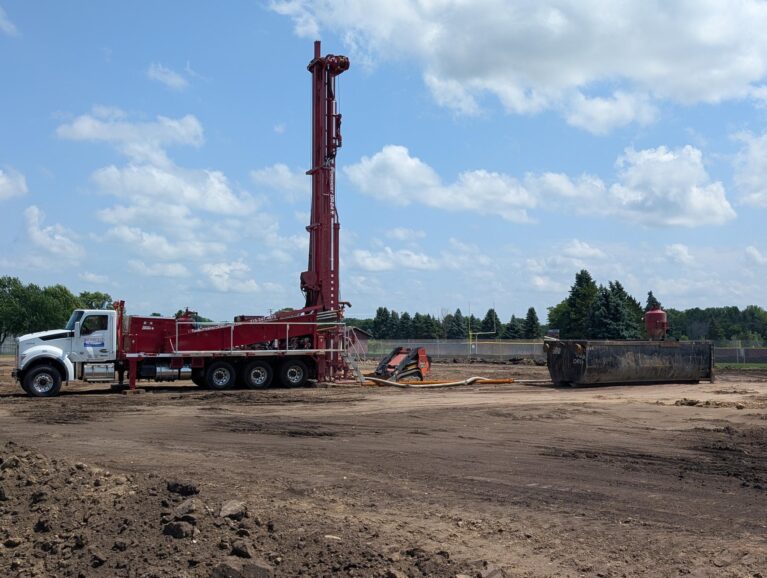

- Completed geothermal well drilling.
- Began installation of geothermal pit-less adapters.
- Cleared the site in Area G (music addition) and Area H (activity center).
- Installed fire hydrant in northeast parking lot.
- Relocated Xcel Energy transformer.
- Completed sanitary/storm sewer connections at the south parking lot.
Anticipated activity for the week of October 19-23, 2026:
- Continue excavation and soil corrections at Area H (activity center).
- Continue concrete footing and foundation installation at Areas P, Q, and R (classroom addition).
- Continue underground electrical work.
- Install underground storm drainage piping in Area G (music addition).
- Excavate Area G (music addition).
- Continue demolition of south vestibule wall by Door 1.
- Backfill Area N (auxiliary gym) former mezzanine space.
We appreciate your patience and cooperation as we reimagine Northfield High School.
– Updated October 19, 2026
Construction Cameras
Cameras have been installed to view construction progress. Camera 1 is located above the Memorial Field concession stand and will provide images of the south parking lot construction, music addition construction, and expanded gymnasium construction. Camera 2 is located above the main entrance door 1 on the roof and will provide images of the classroom addition. Click the link below to view both camera views.
📷 View the Reimagine Northfield High School Construction Camera Timelapse
Drone Footage
A drone was also flown over the site on and shows aerial views of the progress being made on the site:
🎬 View the Sept.18-25 time lapse of the classroom addition.
This shows progress from the past week of rain to excavation of concrete footing trenches, to rebar, to first concrete footing pours.
🎬 View the Sept. 24 Drone Flyover No. 1.
This shows the new music/storm shelter addition, new south parking lot, geothermal well field, and classroom addition. Excavations and soil correction will continue for the next two and a half weeks. Concrete footings and foundation work is scheduled to start Oct. 14 on the music/storm shelter addition.
🎬 View the Sept. 24 Drone Flyover No. 2.
This shows the new classroom addition moving east and then south towards the geothermal well field. Concrete footings and foundation work will continue through the next month and a half. The first precast wall is scheduled to arrive and be set on Nov. 11.
